Highway 401 Expansion: Driving Progress Through Innovation

Estimated reading time: 7 minutes
As infrastructure demands grow across Canada, the need for innovative approaches to design and construction has never been greater. The Highway 401 Expansion Project from Mississauga to Milton demonstrates how advanced engineering solutions, collaborative delivery models, and cutting-edge technologies can overcome challenges. These approaches accelerate timelines and deliver enduring value to the public.
A Milestone In Canadian Transportation

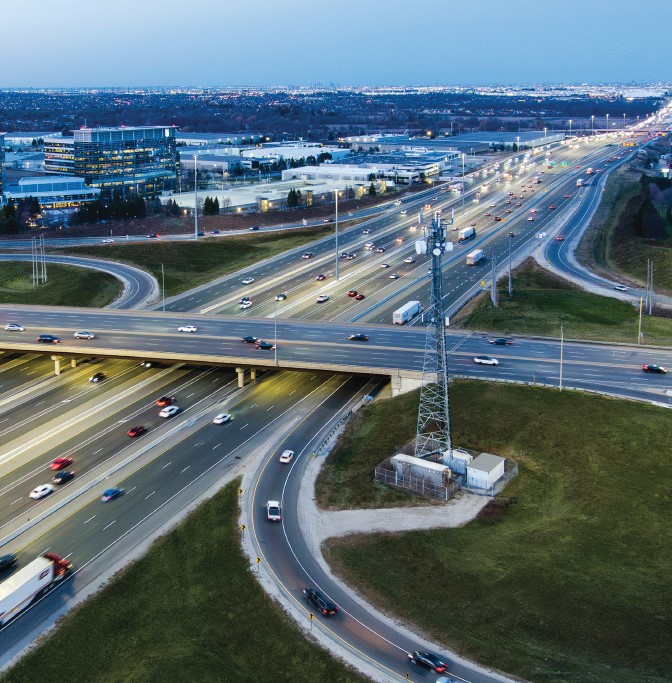

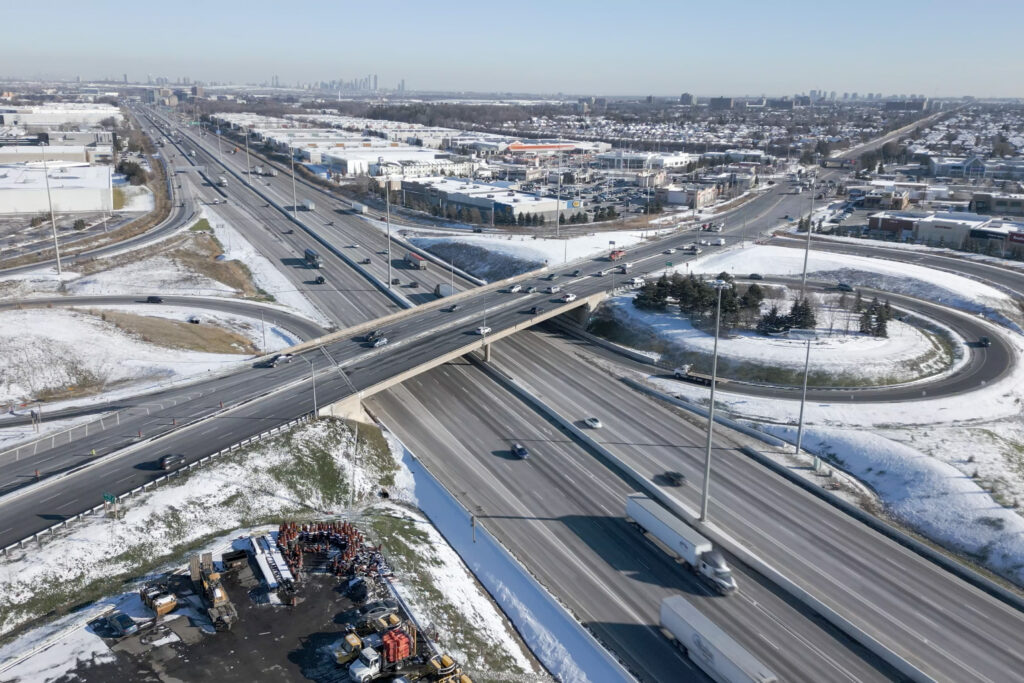

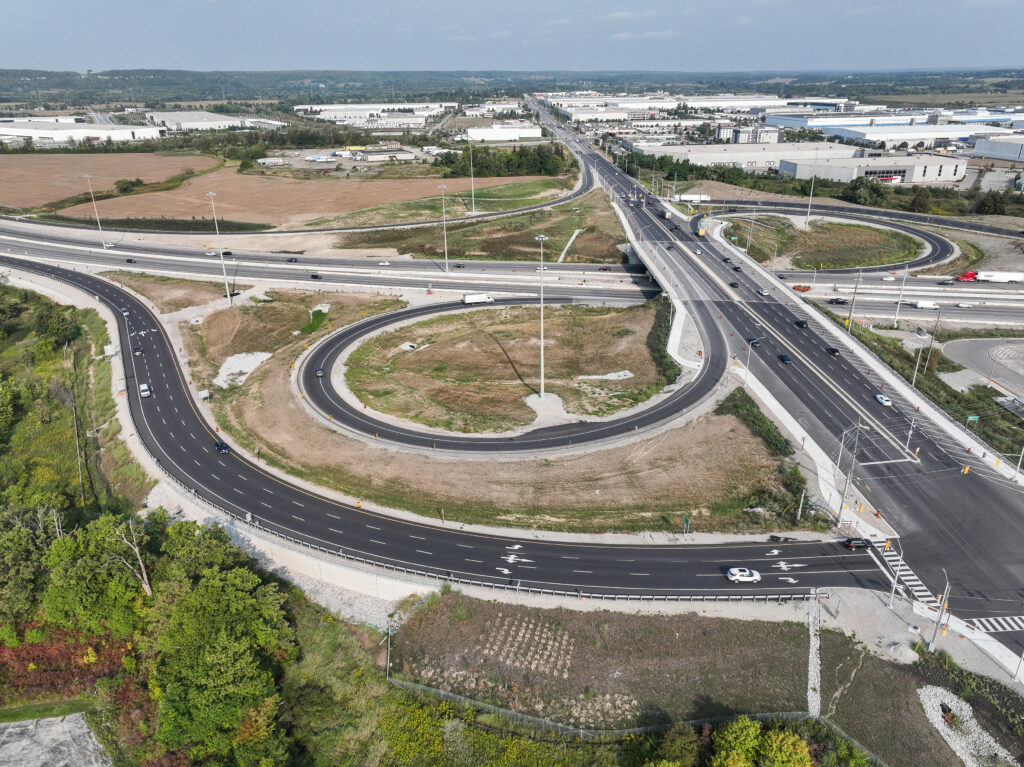

The Highway 401 Expansion widened and reconstructed 18 kilometers of North America’s busiest corridors. It improved safety, eased congestion, and enhanced connectivity across the Greater Toronto Area. Delivered by West Corridor Constructors (WCC), a joint venture of Parsons, Aecon, and Amico, the project was completed on an aggressive schedule, throughout which full traffic flow was maintained. Even more remarkably, this was achieved under the pressures of the pandemic.
The project increased capacity from 3 lanes to 5 lanes in each direction, with express/collector sections reaching 6 lanes. Highway 401 carries approximately 180,000 vehicles daily in this section, making it a critical economic artery. The expansion addressed congestion, improved safety, and introduced innovative solutions to meet the needs of this vital corridor.
Why The P3 Model Worked?
Faced with a tight delivery timeline, Ontario’s Ministry of Transportation (MTO) and Infrastructure Ontario (IO) determined that a Design-Build-Finance approach would offer the best value. The Value-for-Money (VFM) assessment confirmed savings of 19.5% when compared with traditional delivery methods. The P3 structure enabled overlapping design and construction activities and early works. Additionally, a strong governance framework streamlined decision-making and managed risk effectively.
The project team relied on advanced technologies and innovative construction methods to deliver the project efficiently and safely within the required schedule. These innovations included on-site recycling, digital twin technology, and barrier wall optimization. Collectively, these enhancements improved the project’s sustainability, safety, and operational effectiveness.
On-Site Recycling
Reconstructing the median of the highway while maintaining traffic flow posed significant logistical challenges. Traditionally, this process would involve removing road materials, transporting them off-site, and bringing new materials back to the site. To address these issues, the project team implemented an innovative on-site recycling approach.
Mobile crushers were brought to the work zone to process asphalt, concrete, and granular base materials into Granular A, meeting Ontario Provincial Specification Standard (OPSS) requirements. This approach recycled approximately 650,000 tons of granular material and 750,000 tons of asphalt. It eliminated the need for off-site trucking and reduced environmental impacts. The recycling process also improved site cleanliness and accelerated the project schedule. Through the mobile crushing operation, it assisted the schedule, by allowing concurrent works, such as installing high mast foundations and storm sewers immediately following the crushing operations. This innovation not only reduced costs and emissions but also improved safety and minimized truck traffic on live lanes of Highway 401.




Digital Twin Technology
The team leveraged Parsons’ Paradim® platform to create a comprehensive digital twin of the project.
This digital representation of the physical and functional characteristics of the highway served as a centralized hub for collaboration. It facilitated design, scheduling, construction, quality, commissioning, and closeout processes among the teams.
The digital twin was particularly instrumental in the commissioning process. It allowed deficiencies to be recorded, visualized, and rectified efficiently. Using a mobile application integrated into the platform, deficiencies were documented with descriptions, photographs, and GPS locations. This enabled seamless tracking and resolution. The dashboard provided real-time status of deficiencies and issues on the project. This innovative use of digital technology streamlined operations. Moreover, it improved communication and ensured quality standards were consistently met.
Barrier Wall Optimization
Designing the highway to fit within the constrained right-of-way while minimizing the use of barrier walls posed another significant challenge. Barrier walls, while necessary in some areas, can introduce hazards and increase costs. The design team conducted explicit road safety analyses to explore alternatives to the standard approach of adding barrier walls.
These analyses compared options such as narrowing shoulders, reducing lane widths, and steepening roadside slopes. The goal was to identify solutions with the least societal cost while maintaining safety. This approach reduced the number of barrier walls required, improving overall highway safety. Additionally, it reduced societal costs. Post-construction, road safety audits were conducted to address perceived safety concerns. This ensured the best alternatives were implemented, even in areas compliant with design standards.
Lessons In Collaboration
The success of the Highway 401 Expansion Project was built on a foundation of strong collaboration, unified goals, and a commitment to innovation. The co-location of teams from WCC, IO, and the MTO fostered a highly integrated and cooperative environment. This close proximity allowed for real-time communication and faster decision-making. It also facilitated the ability to address challenges as they arose. Thus, ensuring the project stayed on schedule and within scope despite the work’s complexities.
One of the key aspects of the collaboration was the seamless integration of design and construction teams.
Parsons, as the lead design engineer and a Design-Build joint venture partner, worked closely with construction teams. This ensured that designs were not only technically sound but also constructible and efficient. This integration allowed for the development of dynamic staging plans. These plans enabled construction to proceed while maintaining traffic flow. The staging approach involved widening the highway on the outside first, shifting traffic to the newly constructed lanes, and then reconstructing the median. This phased approach required coordination between design and construction teams. It was essential to adapt to field conditions and ensure safety for both workers and the traveling public.
Working With Stakeholders
Additionally, the project team worked closely with stakeholders, including local municipalities and utility providers with the aim was of coordinating activities and minimizing disruptions to the public. Regular updates and communication on the website and notices kept motorists informed about construction progress and traffic impacts. By maintaining open lines of communication and fostering a spirit of partnership, the project team was able to build trust. It also ensured the smooth execution of the work.
The Highway 401 Expansion Project demonstrates how collaboration, when combined with innovative tools and a shared commitment to excellence, can overcome even the most complex challenges. The integration of design, construction, and stakeholder engagement was key to the project’s success.
Building Canada’s Future
The Highway 401 Expansion Project stands as a benchmark for modern infrastructure delivery in Canada. It illustrates how advanced engineering solutions, collaborative partnerships, and innovative technologies can overcome complex challenges. Simultaneously, it delivers long-term economic and community benefits.
We are proud to be part of this achievement, not just as a global infrastructure leader, but as a committed member of Canada’s engineering community. We are helping to shape the nation’s transportation legacy for generations to come.
